Skip to main content

Resource Management

info

This functionality is available only in the PRO edition.

Gantt provides predefined resource views for highlighting resource load, methods for breaking down a project by resource for load balancing, and task- and resource-specific work-time calendars.

resource_panel

note

Although Gantt itself does not calculate the resource load and does not have any methods that can be used out of the box, Gantt provides you with a public API for implementing any custom behavior.

Resource view panel​

dhtmlxGantt has two types of predefined layout views for displaying resource load in Gantt: resource load diagram and resource histogram.

Resource load diagram​

It includes corresponding views for the grid and timeline: "resourceGrid" and "resourceTimeline".

resource_panel

Note

You need to pass a separate config for "resourceGrid" (to display columns for resources not for tasks) and "resourceTimeline" views, and templates to configure display of the resource assignments in the panel.

gantt.config.layout = {
css: "gantt_container",
rows: [
{
// layout for default Grid and Timeline
cols: [
{ view: "grid", group: "grids", scrollY: "scrollVer" },
{ resizer: true, width: 1 },
{ view: "timeline", scrollX: "scrollHor", scrollY: "scrollVer" },
{ view: "scrollbar", id: "scrollVer", group: "vertical" }
],
gravity: 2
},
{ resizer: true, width: 1 },
{
// layout for Grid and Timeline of resource panel
config: resourceConfig, // config for Grid and Timeline
cols: [
{ view: "resourceGrid", group: "grids", width: 435,
scrollY: "resourceVScroll"
},
{ resizer: true, width: 1 },
{ view: "resourceTimeline", scrollX: "scrollHor",
scrollY: "resourceVScroll"
},
{ view: "scrollbar", id: "resourceVScroll", group: "vertical" }
],
gravity: 1
},
{ view: "scrollbar", id: "scrollHor" }
]
};

Related sample: Resource load diagram

Once initialized, resourceGrid will work in the same way as the default grid view, but readonly. resourceTimeline will inherit the scale configuration from the default timeline and will have two layers:

  • background rows, which inherit task_row_class and timeline_cell_class. The templates of resourceTimeline can be redefined at the layout level.
  • resource layer - a layer specific to resourceTimeline. It will display blocks in cells where the resource has tasks assigned. The block style and content can be templated with the resource_cell_class and resource_cell_value templates:
gantt.templates.resource_cell_value = function (start_date, end_date, resource, tasks) {
let result = 0;
// iterate all tasks
tasks.forEach(function (item) {
const assignments = gantt.getResourceAssignments(resource.id, item.id);
// add values from all assignments
assignments.forEach(function (assignment) {
const task = gantt.getTask(assignment.task_id);
result += assignment.value * 1;
});
});

if (result % 1) {
result = Math.round(result * 10) / 10;
}
return "<div>" + result + "</div>";
};

This example sums the values of every assignment found for the resource on each task in the cell. Since getResourceAssignments is not limited to the cell's date range, the total reflects the resource's overall assigned value for the task rather than a value split across the cells the task spans, so the same total appears in every cell the task touches.

You can also use the same template to render fully custom markup instead of a numeric value, as shown below:

gantt.templates.resource_cell_value = function (start_date, end_date, resource, tasks) {
// random bar heights, replace with real values in a production template
const capacity1 = `height: ${Math.round(Math.random(100) * 44)}px;`;
const capacity2 = `height: ${Math.round(Math.random(100) * 44)}px;`;

// half of the cell width so both bars fit side by side
const barWidth = `width: ${gantt.getScale().col_width / 2}px;`;

// two bars rendered inside the cell
var html = `
<div style={{height: '44px', display: 'flex', alignItems: 'flex-end'}}>
<div style={{background: 'plum'}}></div>
<div style={{background: 'orange'}}></div>
</div>
`
return html;
};

If you use an earlier version of Gantt that doesn't support resource assignments, or simply want to visualize resource load without relying on resource assignments, you can use the following approach instead:

// assume each task takes 8 hours
gantt.templates.resource_cell_value = (start_date, end_date, resource, tasks, assignments) =>
`<div>${tasks.length * 8}h</div>`;

This example estimates the resource's load from the number of tasks in the cell alone, assuming a fixed 8-hour workload per task, instead of reading actual assignment values.

Related sample: Templates of the Resource diagram

Resource histogram​

This type of layout view for displaying resource load in Gantt includes the "resourceGrid" and "resourceHistogram" views for the grid and timeline, correspondingly.

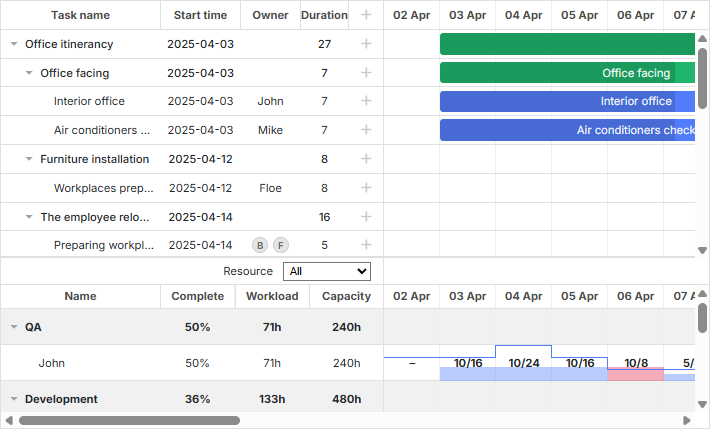

Resource histogram

Note

You need to pass a separate config for "resourceGrid" (to display columns for resources not for tasks) and "resourceHistogram" views, and templates to configure display of the resource assignments in the panel.

gantt.config.layout = {
css: "gantt_container",
rows: [
{
// layout for default Grid and Timeline
gravity: 2,
cols: [
{ view: "grid", group: "grids", scrollY: "scrollVer" },
{ resizer: true, width: 1 },
{ view: "timeline", scrollX: "scrollHor", scrollY: "scrollVer" },
{ view: "scrollbar", id: "scrollVer", group: "vertical" }
]
},
{ resizer: true, width: 1, next: "resources" },
{
// layout for Grid and Timeline of resource panel
gravity: 1,
id: "resources",
config: resourceConfig, // config for Grid and Timeline
templates: resourceTemplates, // templates for Grid and Timeline
cols: [
{ view: "resourceGrid", group: "grids", scrollY: "resourceVScroll" },
{ resizer: true, width: 1 },
{
view: "resourceHistogram",
capacity: 24,
scrollX: "scrollHor",
scrollY: "resourceVScroll"
},
{ view: "scrollbar", id: "resourceVScroll", group: "vertical" }
]
},
{ view: "scrollbar", id: "scrollHor" }
]
};

Related sample: Resource histogram

As with the resource load diagram, resourceGrid works the same way as the default grid view, but in readonly mode. resourceHistogram has the following additional templates:

  • histogram_cell_class - the CSS class which is applied to a cell of the resource panel
gantt.templates.histogram_cell_class = function (start_date, end_date, resource, tasks) {
// total hours assigned to the resource within this cell
let result = 0;
tasks.forEach(function (item) {
const assignments = gantt.getResourceAssignments(resource.id, item.id);
assignments.forEach(function (assignment) {
result += assignment.value * 1;
});
});

return result > 8 ? "column_overload" : "";
};

If your Gantt version doesn't support resource assignments, or you'd rather not rely on them, this simpler template can be used instead:

// assume each task takes 8 hours per day
gantt.templates.histogram_cell_class = (start_date, end_date, resource, tasks, assignments) =>
tasks.length * 8 > 8 ? "column_overload" : "";

This variant estimates the same overload state from the task count alone, assuming each task takes 8 hours per day, instead of using actual assignment values.

  • histogram_cell_label - the label inside a cell
gantt.templates.histogram_cell_label =
function (start_date, end_date, resource, tasks, assignments) {
// total hours assigned to the resource within this cell
const hours = assignments.reduce((sum, assignment) => sum + assignment.value * 1, 0);
return `${hours}h`;
};

If you're running an earlier version of Gantt that doesn't support resource assignments, or simply want a simpler calculation, use this approach instead:

// assume each task takes 8 hours
gantt.templates.histogram_cell_label = (start_date, end_date, resource, tasks, assignments) => tasks.length * 8;

This approach calculates the label from the task count alone, treating each task as an 8-hour block, rather than pulling the actual assignment values.

  • histogram_cell_allocated - the height of the filled area in the histogram. Its value can be set from 0 to maxCapacity *.
gantt.templates.histogram_cell_allocated =
function (start_date, end_date, resource, tasks, assignments) {
// height of the filled area matches the resource's total assigned hours for the cell
return assignments.reduce((sum, assignment) => sum + assignment.value * 1, 0);
};

If your version of Gantt is too old to support resource assignments, or you'd rather not depend on them, the filled height can also be approximated like this:

// assume each task takes 8 hours
gantt.templates.histogram_cell_allocated = (start_date, end_date, resource, tasks, assignments) => tasks.length * 8;

This alternative sizes the filled area purely by task count, treating every task as an 8-hour block regardless of what's actually assigned to the resource.

  • histogram_cell_capacity - the height of the line that defines the available capacity of the resource. Its value can be set from -1 to maxCapacity *. Values less than 0 won't render the line.
gantt.templates.histogram_cell_capacity = (start_date, end_date, resource, tasks, assignments) => 24;

What maxCapacity is

If each row of the histogram is considered to be a bar chart, maxCapacity is the height of the Y-scale of this chart. In the image below maxCapacity = 24:

maxCapacity

Thus, if the templates histogram_cell_allocated or histogram_cell_capacity are set to a value of 24, it implies the highest point of the row.

By default, maxCapacity is 24 for all resources. It means that if you return a value greater than 24 in the histogram_cell_capacity template, the numbers will be calculated correctly, but the area of the cells of the resource panel may not be filled as expected.

filled_capacity

But there is the ability to configure maxCapacity for the whole histogram at once and for each resource separately. Check the example below:

Related sample: Configuring maxCapacity

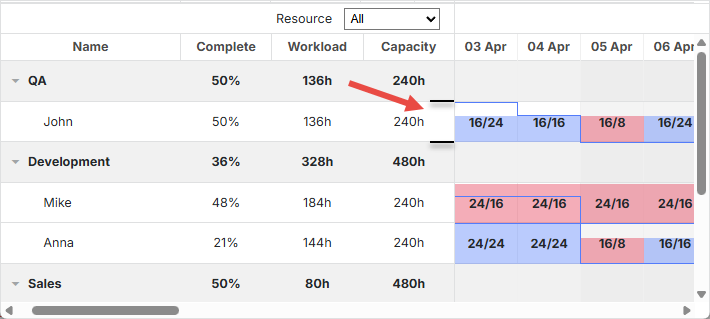

maxCapacity can be defined either at the histogram level:

{ view: "resourceHistogram", capacity: 24, scrollX: "scrollHor", scrollY: "resourceVScroll" }

or individually for each resource:

resourcesStore.parse([
{ id: 1, text: "John", capacity: 8 },
{ id: 2, text: "Mike", capacity: 4 },
{ id: 3, text: "Anna", capacity: 8 },
{ id: 4, text: "Bill", capacity: 8 },
{ id: 5, text: "Floe", capacity: 8 }
]);
note

Capacity defined at the resource level overrides the global capacity of histogram for a given resource.

Working with resource view panel​

By default both views (either "resourceGrid" and "resourceTimeline" or "resourceGrid" and "resourceHistogram") will be bound to the data store named in the gantt.config.resource_store configuration option.

Auto creation of data store​

From v8.0, the data store for resources will be created automatically during the initialization of the gantt and will be available by the time "onGanttReady" is called. To use the datastore created by gantt, apply the gantt.getDatastore method.

If you need to provide an extra configuration to the resource store, you can use the new gantt.config.resources option:

gantt.config.resources = {
resource_store: {
type: "treeDataStore",
fetchTasks: true,
initItem: item => {
item.parent = item.parent || gantt.config.root_id;
item[gantt.config.resource_property] = item.parent;
item.open = true;
return item;
}
}
};

Settings passed to resource_store will be used by the gantt to create the default resource datastore. If you've already created the resource datastore in your code, the gantt will use your store instead.

In order to load resources, you can either pass resources into the gantt.parse()/gantt.load() methods as described here, or you can access the datastore and populate it using the datastore.parse() method:

gantt.attachEvent("onGanttReady", () => {
const store = gantt.getDatastore(gantt.config.resource_store);
store.parse([
{ id: 6, text: "John" },
{ id: 7, text: "Mike" },
{ id: 8, text: "Anna" },
{ id: 9, text: "Bill" }
]);
});

The resource control of the lightbox will be connected to the resource list automatically:

gantt.config.lightbox = {
sections: [
...,
{ name: "resource_selector", label: "Resources", type: "resource_selector", map_to: "auto" }
]
};

Manual creation of data store​

It is also possible to initialize the data store manually with the help of the createDatastore method:

const resourcesStore = gantt.createDatastore({
name: gantt.config.resource_store,
// Use treeDatastore if you have hierarchical resources (e.g. workers/departments),
// skip the "type" if you have a flat structure when you don't use the assignments or render everything manually
type: "treeDatastore",
initItem: item => {
item.parent = item.parent || gantt.config.root_id;
item[gantt.config.resource_property] = item.parent;
item.open = true;
return item;
}
});

In order to populate the data store, use the datastore.parse method:

resourcesStore.parse([
{ id: 1, text: "QA", parent: null },
{ id: 2, text: "Development", parent: null },
{ id: 3, text: "Sales", parent: null },
{ id: 4, text: "Other", parent: null },
{ id: 5, text: "Unassigned", parent: 4 },
{ id: 6, text: "John", parent: 1 },
{ id: 7, text: "Mike", parent: 2 },
{ id: 8, text: "Anna", parent: 2 },
{ id: 9, text: "Bill", parent: 3 },
{ id: 10, text: "Floe", parent: 3 }
]);

If you want to use resources in the lightbox, it might be a good idea to do it via the serverList method from the onParse event of the data store:

resourcesStore.attachEvent("onParse", () => {
const people = [];
resourcesStore.eachItem(res => {
if (!resourcesStore.hasChild(res.id)) {
const copy = gantt.copy(res);
copy.key = res.id;
copy.label = res.text;
people.push(copy);
}
});
gantt.updateCollection("resourceOptions", people);
});

Expanding resources panel​

It is possible to expand the resources panel to show all the tasks assigned to a particular resource by enabling the fetchTasks property during initialization of the datastore:

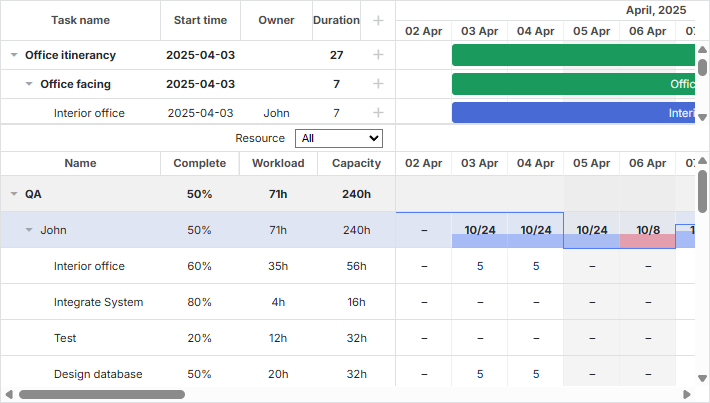

Expanded resource panel

gantt.config.resources = {
resource_store: {
type: "treeDataStore",
fetchTasks: true, /*!*/
initItem: item => {
item.parent = item.parent || gantt.config.root_id;
item[gantt.config.resource_property] = item.parent;
item.open = !item.parent;
return item;
}
}
};

or

gantt.$resourcesStore = gantt.createDatastore({
name: gantt.config.resource_store,
type: "treeDatastore",
fetchTasks: true, /*!*/
initItem: item => {
item.parent = item.parent || gantt.config.root_id;
item[gantt.config.resource_property] = item.parent;
item.open = !item.parent;
return item;
}
});

Related sample: Show all assigned tasks in the resource panel

With the fetchTasks property set to true, Gantt renders all tasks assigned to a certain resource in the resource view panel. This functionality works for both the resource diagram and resource histogram layout types.

There is a shorthand for getting all tasks assigned to a resource - getResourceAssignments.

gantt.getResourceAssignments("6");

Assigning resources​

Connecting resources to tasks​

When effort-driven calculations are enabled, an assignment's value is the allocation per full working day in the configured work unit, hours per day by default.

The resource relation is defined by the resource_property configuration option:

gantt.config.resource_property = "user_id";
// task.user_id <-> resource.id

Resources can be connected to tasks via the properties of the task object in one of the following ways:

  • assigning one resource to one task
{
id: 1, text: "Task #1", start_date: "02-04-2018", duration: 8, progress: 0.6,
user_id: 5 // 5 is the id of the resource
}
  • assigning multiple resources to one task
{
id: 1, text: "Task #1", start_date: "02-04-2018", duration: 8, progress: 0.6,
users: [2, 3] // 2 and 3 are the ids of resources
}

You can use this format with the custom multiselect control.

  • assigning multiple resources and specifying their quantity
{
id: 1, text: "Task #1", start_date: "02-04-2025", duration: 8, progress: 0.6,
users: [{resource_id: 2, value: 8}, {resource_id: 3, value: 4}]
}

The resources are assigned to Task #1 as follows: the resource with id="2" is assigned in a quantity of 8 units, and the resource with id="3" in a quantity of 4 units. This format is supported by the Resources Control and Resource Assignments control of the lightbox.

Starting from v8.0, you can also load resource assignments as a separate list, and Gantt will connect them to tasks automatically:

gantt.parse({
tasks: [...],
links: [...],
resources: [...],
assignments: [{id: 1, resource_id: 2, task_id: 5, value: 8}, ...]
});

You can read more about data formats here.

When sending data to the server, DataProcessor serializes the values of the described properties into JSON. To process such records on the server with ease, make use of the "REST_JSON" dataprocessor mode.

In some cases, you may want to save changes in Resource Assignments separately from task objects. In this case, you can enable the following config:

gantt.config.resources = {
dataprocessor_assignments: true,
dataprocessor_resources: true,
};

Read more about it in a separate article.

Setting the time of the resource assignments​

By default, the resource is considered to be assigned for the whole duration of a task.

On a paused task, the assignment's delay and fixed duration count work time, skipping pauses. Inactive tasks are excluded from resource load calculations. See Inactive Tasks and Links.

Starting from v7.1, the resource assignment object can accept additional optional parameters that allow specifying the dates of the assignment within the task.

The additional properties are:

  • id - (string|number) the id of the assignment
  • start_date - (Date|string) the date the assignment is scheduled to start
  • end_date - (Date|string) the date the assignment is scheduled to be completed
  • delay - (number) the difference between the assignment start date and the task start date
  • duration - (number) the duration of the assignment
  • mode - (string) the calculation mode of the time of the resource assignment: "default"|"fixedDates"|"fixedDuration"
{
id: 5, text: "Interior office", type: "task", start_date: "03-04-2025 00:00",
duration: 7, parent: "2", progress: 0.6, priority: 1,
users: [
{
resource_id: "3",
value: 8,
delay: 1
},
{
resource_id: "6",
value: 3,
start_date: "03-04-2025 00:00",
end_date: "05-04-2025 00:00",
mode: "fixedDates"
},
{
resource_id: "7",
value: 3,
delay: 1,
duration: 2,
mode: "fixedDuration"
}
]
}

Related sample: Assign resource values to specific days

  1. The start and end dates of the resource assignment will be reflected in the resource histogram and diagram.

  2. The optional id property of the assignment can be added to the resource assignment object:

{
id: 1, text: "Task #1", start_date: "02-04-2025", duration: 8, progress: 0.6,
users: [{
id: 5,
resource_id: 2,
value: 8,
delay: 1
}]
}

The assignment object will be accessible for the gantt API via this id:

const assignment = gantt.getDatastore("resourceAssignments").getItem(5);
Note

The "resourceAssignments" datastore is only available when the process_resource_assignments config is enabled.

  1. The work of the rest properties is defined by the value of the mode property:
  • the "default" mode
{
id: 1, text: "Task #1", start_date: "02-04-2025", duration: 8, progress: 0.6,
users: [
{ resource_id: 2, value: 8, delay: 1},
{ resource_id: 3, value: 6},
]
}

If the mode is not specified or is set to the "default" value, the start_date and end_date of the assignment are calculated from the dates of the task. By default, the start date of the assignment matches the start date of the task. The same approach is applied to the end date.

The delay property works similarly to the Delay property of MS Project.

If the delay is specified, the start_date of the assignment is calculated as

gantt.calculateEndDate({start_date:task.start_date, duration:assignment.delay, task:task}).

The resource assignment will start with the specified delay from the start of the task. The end date of the assignment will match the end date of the task.

Whenever the task object is updated, the start/end dates of the assignment will be updated accordingly.

  • the "fixedDuration" mode
{
id: 1, text: "Task #1", start_date: "02-04-2025", duration: 8, progress: 0.6,
users: [
{ resource_id: 2, value: 8, duration: 1, delay: 0, mode: "fixedDuration" },
{ resource_id: 2, value: 2, duration: 1, delay: 1, mode: "fixedDuration" },
{ resource_id: 2, value: 3, delay: 2, mode: "default" }
]
}

The start_date of the assignment is calculated in the same way as it's calculated in the "default" mode.

The end_date is no longer linked to the end date of the task. Instead, it's calculated as

gantt.calculateEndDate({start_date:assignment.start_date, duration:assignment.delay, task:task}).

Whenever the task object is updated, the dates of the assignments are recalculated, and the durations of the assignments remain unchanged.

  • the "fixedDates" mode
{
id: 1, text: "Task #1", start_date: "02-04-2025", duration: 8, progress: 0.6,
users: [{
resource_id: 2, value: 8,
start_date: "03-04-2025", end_date: "11-04-2025", mode: "fixedDates"
}]
}

In this mode, the dates of the resource assignment have exactly the same values as specified in the data and are not changed when the task is modified.

The delay field doesn't affect the dates of the assignment when the "fixedDates" mode is used.

Here is a short summary of how assignment dates are calculated in each mode:

  • default

    • assignment.start_date = task.start_date + assignment.delay
    • assignment.end_date = task.end_date
  • fixedDuration

    • assignment.start_date = task.start_date + assignment.delay
    • assignment.end_date = assignment.start_date + assignment.duration
  • fixedDates

    • assignment.start_date = assignment.start_date
    • assignment.end_date = assignment.end_date

Getting tasks a resource is assigned to​

There is a shorthand for getting all tasks assigned to a resource - getResourceAssignments.

gantt.getResourceAssignments("6");

The method takes as a parameter the id of the resource and returns an array of objects with tasks assigned to the resource:

[
{ task_id: 5, resource_id: "6", value: 5, delay: 0, duration: 7,
start_date: "03-04-2025 00:00", end_date: "12-04-2025 00:00",
id: 1617258553240, mode: "default" },
{ task_id: 18, resource_id: "6", value: 2, delay: 0, duration: 2,
start_date: "05-04-2025 00:00", end_date: "09-04-2025 00:00",
id: 1617258553250, mode: "default" },
{ task_id: 19, resource_id: "6", value: 3, delay: 0, duration: 4,
start_date: "09-04-2025 00:00", end_date: "13-04-2025 00:00",
id: 1617258553251, mode: "default" },
{ task_id: 21, resource_id: "6", value: 5, delay: 0, duration: 4,
start_date: "03-04-2025 00:00", end_date: "09-04-2025 00:00",
id: 1617258553254, mode: "default" }
]

Each object contains the following properties:

  • task_id - the id of the task
  • resource_id - the id of the resource
  • value - the quantity of the resource assigned to a task
  • delay - the difference between the assignment start date and the task start date
  • duration - the duration of the assignment
  • start_date - the date the assignment is scheduled to start
  • end_date - the date the assignment is scheduled to be completed
  • id - the id of the assignment
  • mode - the calculation mode of the time of the resource assignment: "default"|"fixedDates"|"fixedDuration"

Getting resource assignments of a task​

The getTaskAssignments method allows getting the parsed resource assignments of a specific task from the datastore:

gantt.getTaskAssignments(5);

The method takes as a parameter the id of the task and returns an array of objects with the resource assignments of the task:

[
{ task_id: 5, id: 1617254693938, delay: 0, duration: 2,
start_date: "03-04-2025 00:00", end_date: "05-04-2025 00:00",
mode: "fixedDuration", resource_id: 6, value: 3 },
{ task_id: 5, id: 1617254693946, delay: 3, duration: 1,
start_date: "06-04-2025 00:00", end_date: "07-04-2025 00:00",
mode: "fixedDuration", resource_id: 6, value: 6 }
]

The return object contains the same list of properties as the return object of the getResourceAssignments method.

Setting connection via lightbox​

Resources can be assigned to any property of the task object using the built-in lightbox.

gantt.serverList("people", [
{ key: 1, label: "John" },
{ key: 2, label: "Mike" },
{ key: 3, label: "Anna" },
{ key: 4, label: "Bill" },
{ key: 7, label: "Floe" }
]);

gantt.locale.labels.section_owner = "Owner";

gantt.config.lightbox.sections = [
{ name: "description", height: 38, map_to: "text", type: "textarea", focus: true },
{ name: "owner", map_to: "owner_id", type: "select",
options: gantt.serverList("people") },
{ name: "time", type: "duration", map_to: "auto" }
];

Read about how to configure the resource control of the lightbox in the Resources Control and Resource Assignments control articles.

Loading collections​

Collections specified as server lists can be loaded and updated dynamically, after gantt is initialized:

// init lightbox with an empty collection
gantt.locale.labels.section_owner = "Owner";

gantt.config.lightbox.sections = [
{ name: "description", height: 38, map_to: "text", type: "textarea", focus: true },
{ name: "owner", map_to: "owner_id", type: "select",
options: gantt.serverList("people") },
{ name: "time", type: "duration", map_to: "auto" }
];

// once options are loaded
gantt.updateCollection("people", [
{ key: 1, label: "John" },
{ key: 2, label: "Mike" },
{ key: 3, label: "Anna" },
{ key: 4, label: "Bill" },
{ key: 7, label: "Floe" }
]);

resource_management

Related sample: Assigning owners to tasks

If you define resources via the serverList collection, they can be loaded together with the rest of the data, otherwise you'll need to load them manually.

Read about how to configure the resource control of the lightbox in the Resources control and Resource Assignments control articles.

Loading resources and resource assignments​

From v8.0, resources and resource assignments can be loaded into the gantt using gantt.parse() or gantt.load() methods:

gantt.parse({
tasks: [
...,
{
id: 5,
text: "Interior office",
type: "task",
start_date: "03-04-2025 00:00",
duration: 7,
parent: "2",
owner: [
{
resource_id: "6",
value: 3,
start_date: "03-04-2025 00:00",
end_date: "05-04-2025 00:00",
}
]
},
...
],
links: [],
resources: [
{ id: 6, text: "John", unit: "hours/day" },
{ id: 7, text: "Mike", unit: "hours/day" },
{ id: 8, text: "Anna", unit: "hours/day" },
{ id: 9, text: "Bill", unit: "hours/day" },
{ id: 10, text: "Floe", unit: "hours/day" }
]
});

Resource assignments can be passed into the method separately from tasks:

gantt.parse({
tasks: [
...,
{
id: 5,
text: "Interior office",
type: "task",
start_date: "03-04-2025 00:00",
duration: 7,
parent: "2",
priority: 1
},
...
],
links: [],
assignments: [
{
id: 1,
task_id: 5,
resource_id: 6,
value: 3,
start_date: "03-04-2025 00:00",
end_date: "05-04-2025 00:00"
}
],
resources: [
{ id: 6, text: "John", unit: "hours/day" },
{ id: 7, text: "Mike", unit: "hours/day" },
{ id: 8, text: "Anna", unit: "hours/day" },
{ id: 9, text: "Bill", unit: "hours/day" },
{ id: 10, text: "Floe", unit: "hours/day" }
]
});

Managing resource assignments​

Parsing resource assignments​

Starting with v7.1, you can work with the resource assignments as with objects of the data store.

The new process_resource_assignments property enables parsing the values of the gantt.config.resource_property from tasks into internal resource assignment objects. As a result, you are able to manipulate the resource assignments via the DataStore object. For instance, you can get the necessary assignment object or update it.

Note that this functionality is required if you want to specify the desired duration and time for the resources when building the resource diagram and histogram.

The process may add noticeable performance overhead, and large projects may start working slower. Therefore, if you don't need to set time or duration of the assignment, you can disable parsing of the resource assignments using the config:

gantt.config.process_resource_assignments = false;

When the config is disabled, the gantt.getDatastore("resourceAssignments") datastore won't be available, and the assignment objects won't have any dynamic properties. The resource diagram and histogram will consider resources to be assigned to the whole duration of the task.

Updating resource assignments​

The resource assignments are stored in the data store which is created automatically.

By default, the store of the assignments is populated from the task objects. This means that if you modify the resource property of the task object (e.g. task.users), the changes will be automatically reflected in the data store.

task[gantt.config.resource_property] = [
{
resource_id: "6",
value: 3,
start_date: "03-04-2025 00:00",
end_date: "05-04-2025 00:00",
}
];

gantt.updateTask(taskId);

But you may need to refresh the data of the assignments in the opposite direction. Namely, you may need to apply the changes to the task object after the resource assignments are modified via the datastore API. In this case, you need to update the resource property of the task object with the values from the datastore by calling the gantt.updateTaskAssignments() method:

const assignmentStore = gantt.getDatastore(gantt.config.resource_assignment_store);

assignmentStore.addItem({
resource_id: 5,
task_id: 2,
value: 4
});

assignmentStore.removeItem(assignment.id);
assignmentStore.updateItem(assignment.id);

// after the assignments are updated in the datastore, you need
// to call `updateTaskAssignments` to write the changes to the task object:
gantt.updateTaskAssignments(taskId);

Re-rendering resource assignments during task drag​

When a task is being dragged, the resource panel is re-rendered, but the resource assignments are not modified. Only the cells of the resource panel that are affected by the task dragging (by default, only those inside the task dates) are re-rendered.

To update the resource assignments in all the cells, you need either to disable the process_resource_assignments configuration option or update all the resource assignments of the task manually, as it is shown in the example below:

gantt.attachEvent("onTaskDrag", (id, mode, task, original) => {
const assignments = gantt.getTaskAssignments(id);
assignments.forEach(assignment => {
if (assignment.mode === "default") {
assignment.start_date = task.start_date;
assignment.end_date = task.end_date;
}
});
});

Showing task resource​

The resource name can be displayed as part of the task description or as a label in one of the grid cells. Gantt doesn't provide a ready-made method for getting an item specified in the server list by its id, so you'll need to implement a small helper for this:

const byId = (list, id) => {
const item = list.find(item => item.key === id);
return item ? item.label || "" : "";
};

After that you can use the resource name in templates:

gantt.config.columns = [
{ name: "owner", width: 80, align: "center",
template: (item) => byId(gantt.serverList('people'), item.owner_id) },
{ name: "text", label: "Task name", tree: true, width: '*' },
{ name: "add", width: 40 }
];

gantt.templates.rightside_text =
(start, end, task) => byId(gantt.serverList('people'), task.owner_id);

Related sample: Assigning owners to tasks

Editable resource diagram​

In order to make resource assignments editable in the resource diagram, you can use the following configuration:

gantt.config.resources = {
editable_resource_diagram: true
};

Related sample: Assign resource values to specific days

When the editable_resource_diagram property is enabled, gantt will automatically assign gantt.templates.resource_cell_value and gantt.templates.resource_cell_class templates in order to make resource assignments editable in the gantt.

If you assign custom functions to these templates - the gantt will use templates defined by you.

The default implementation of templates is available in the gantt.ext.resources object.

gantt.templates.resource_cell_value = gantt.ext.resources.editableResourceCellTemplate;
gantt.templates.resource_cell_class = gantt.ext.resources.editableResourceCellClass;

Normally, you won't need to assign these templates for the editable diagram manually; this is expected to be handled by Gantt.

In the example below, a template with editable cells is provided. You can customize it if needed:

Related sample: Customizable resource diagram template

Custom styling of resources​

For coloring you'll usually need the following templates:

Depending on your context, you can

Related sample: Assigning owners to tasks

Resource calendars​

Gantt supports the custom work-time calendars feature. Work-time calendars can be associated with specific resources.

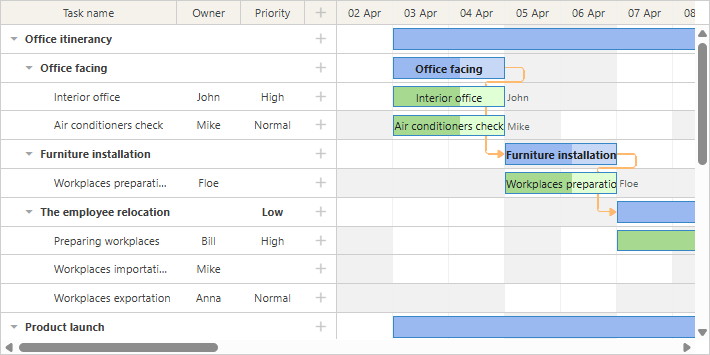

resource_calendars

They are mapped to tasks via the property value in one-to-one relation:

// a resource value will be taken from the `task.resource_id` property
gantt.config.resource_property = "resource_id";

gantt.config.resource_calendars = {
"resource1" : "calendarId1",
"resource2" : "calendarId2",
"resource3" : "calendarId3"
};

You can use any property to assign calendars to resources. If the resource property is changed dynamically, the gantt will automatically recalculate time of tasks using a new calendar.

Related sample: Resource calendars

If multiple resources can be assigned to a single task, Gantt can automatically generate a common calendar for all assigned resources.

You can get more information in the related article.

Balancing resource load​

To calculate a leveled schedule that reduces overloads, use a scheduling provider with resource leveling. See Resource Leveling and Paused Tasks for how Gantt stores and displays the resulting delays and pauses.

You can use the grouping extension to break down the whole project by the resource property.

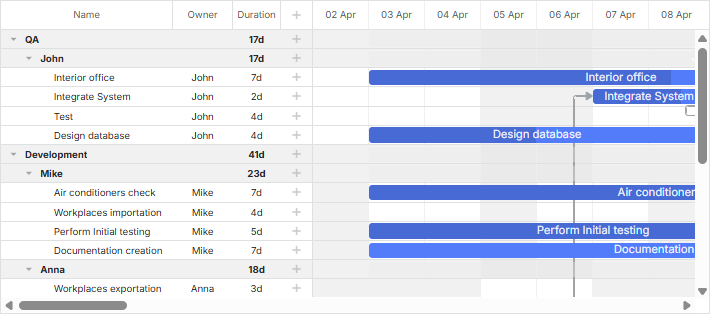

resource_break_down

This feature can be used for balancing resource load in the calendar.

Related sample: Break down by resources

Read more about task grouping in the related article.

Grouping tasks by multiple resources​

If you assign several resources to a task, tasks will be grouped by assigned resources. This means that a task assigned to two persons won't be duplicated for each of them. Instead, it will be rendered once with both persons assigned to it. Note that grouped tasks will be sorted by the start date.

Group resources

Related sample: Group by multiple resources

  • If tasks in the loaded data set have several resources assigned to them, Gantt will create groups for them automatically.
  • For tasks without assigned resources, Gantt will create the default group "Not assigned". If such a group already exists in the data set that is passed into the groupBy() method, it should have the default:true config specified to prevent automatic creation of such a group.
note

Please note that dragging of tasks grouped by multiple resources is impossible.

Need help?
Got a question about the documentation? Reach out to our technical support team for help and guidance. For custom component solutions, visit the Services page.
