Skip to main content

Critical Path

info

This functionality is available only in the PRO edition

A critical path is a sequence of tasks that can't be delayed. Otherwise, the whole project would be delayed.

The critical path also determines the shortest time the project can take.

A task is considered critical if it has no days of slack and any delay would directly affect the project completion date. The detailed explanation of how the logic of calculation of the critical path works is given in the Critical path logic section.

Slack time is the time that a task can slip without affecting other tasks or the project's completion date.

critical_path
note

To start using the extension, enable it using the gantt.plugins method.

To show the critical path in the Gantt chart, set the highlight_critical_path property to 'true':

(Making the Gantt chart to display the critical path)

<!DOCTYPE html>
<html>
<head>
<script src="codebase/dhtmlxgantt.js"></script>
<link href="codebase/dhtmlxgantt.css" rel="stylesheet">
</head>
<body>
gantt.plugins({ /*!*/
critical_path: true /*!*/
}); /*!*/
gantt.config.highlight_critical_path = true;
//your code will be here
</body>
</html>

Critical path

Note that when the property is enabled, dhtmlxGantt will automatically check the status of tasks and update the critical path. Critical tasks and links will have additional 'critical_task' and 'critical_link' CSS classes, respectively.

Each time a task is modified, dhtmlxGantt will completely re-draw data in order to re-calculate the critical path. Sometimes it may create performance issues. For that case, the component provides public methods that allow you to check a certain task or link and implement a performance-friendlier strategy for displaying a critical path.

Critical path logic​

Gantt considers a task as a critical one in the following cases:

  1. The task has the latest end date in the whole chart.

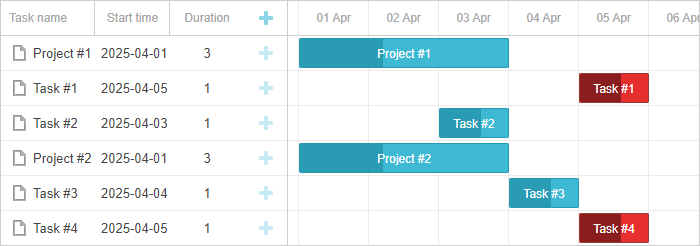

critical_tasks

  1. The task is connected to a critical task, and the lag between them is 0.

The lag depends on the value of the gantt.config.duration_unit parameter. When the duration_unit is set to 'day' and duration between tasks is several hours, Gantt rounds the duration by the following rules:

  • rounds the duration down if it is greater than or equal to 12 hours
  • rounds the duration up if it is less than 12 hours

If the link object includes the lag parameter, it allows changing the duration between tasks. For example, when lag is set to 1, the task becomes critical when the duration between tasks is 1.

Here are some examples with different values of link.lag:

  • link.lag is 0
const tasks = {
"data": [
...
],
"links": [
...
{ "id": 3, "source": 3, "target": 4, "lag": 0, "type": "0" },

]
}

lag0

  • link.lag is 1
const tasks = {
"data": [
...
],
"links": [
...
{ "id": 3, "source": 3, "target": 4, "lag": 1, "type": "0" },

]
}

lag1

  • link.lag is -1
const tasks = {
"data": [
...
],
"links": [
...
{ "id": 3, "source": 3, "target": 4, "lag": -1, "type": "0" },

]
}

lag_1

  1. The gantt.config.project_end parameter is specified and the task dates are greater than the gantt.config.project_end date.

Unfortunately, there is no way to change the built-in logic that defines the critical path. But you can customize the critical path behaviour.

Checking if a task is critical​

To check if some task is critical, use the isCriticalTask method:

gantt.config.highlight_critical_path = true; /*!*/
gantt.init("gantt_here");
gantt.parse(tasks);

gantt.isCriticalTask(gantt.getTask("task3"));// ->'true' /*!*/

Critical path

To check if a link is critical (connects 2 critical tasks), use the isCriticalLink method:

gantt.isCriticalLink(gantt.getLink("link1"));

Critical path

Getting free and total slack​

Free slack - a period of time that can be used to increase the duration of a task or move it on the timeline without affecting the next task it is connected with.

Free slack can be calculated for 'task' and 'milestone' types of tasks.

To get the free slack of a task, make use of the getFreeSlack method. It takes the object of a task as a parameter:

var task = gantt.getTask(7);
gantt.getFreeSlack(task);

Show Slack time

Total slack - a period of time that can be used to increase the duration of a task or move it on the timeline without affecting the time of ending of the whole project.

Total slack can be calculated for all types of tasks, including projects.

To get the total slack of a task, make use of the getTotalSlack method. It takes the object of a task as a parameter as well:

var task = gantt.getTask(7);
gantt.getTotalSlack(task);

Show Slack time

Slack

Customizing the critical path behaviour​

By default, the gantt applies the default behavior to a critical path, such as default style for highlighting, re-calculating the critical path with each data update.

To manipulate the visibility of the critical path, use the following approach:

var isEnabled = false
function updateCriticalPath(){
isEnabled = !isEnabled;

gantt.config.highlight_critical_path = isEnabled;

gantt.render();
}

It can be useful when you have a big number of tasks and re-calculating the critical path may affect the performance.

To manually re-calculate the critical path and apply the related styling, use the following approach:

gantt.templates.task_class = function(start, end, task){
if(gantt.isCriticalTask(task))
return "critical_task";
return "";
};

gantt.templates.link_class = function(link){
if(gantt.isCriticalLink(link))
return "critical_link";
return "";
};

var data = {
tasks: [
{ id: 1, text: "Office itinerancy", open:true, type:"project" },
{ id: 2, text: "Office facing", start_date: "21-07-2020",
duration: "20", parent: "1" },
{ id: 3, text: "Furniture installation", start_date: "21-07-2020",
duration: "5", parent: "1" },
{ id: 4, text: "The employee relocation", start_date: "28-07-2020",
duration: "15", parent: "1" },
{ id: 5, text: "Interior office", start_date: "28-07-2020",
duration: "15", parent: "1" }
],
links: [
{ id: "1", source: "2", target: "3", type: "0" },
{ id: "2", source: "3", target: "4", type: "0" },
{ id: "3", source: "4", target: "5", type: "0" }
]
};
gantt.init("gantt_here");

gantt.parse(data);

It is also possible to highlight tasks and links manually:

  • If you return "gantt_critical_task" in the task_class template, the task will be highlighted as a critical one.
  • If you return "gantt_critical_link" in the link_class template, the link will be highlighted as a critical one.

Related sample: Custom critical path per project

Setting lag and lead times between tasks​

It's possible to set lag and lead times between tasks of the critical path. You find the details here.

Scheduling completed tasks​

By default, there is no difference in how the critical path algorithm processes completed tasks (tasks which have progress value of 1) and incomplete tasks.

Optionally, you can enable the auto_scheduling_use_progress config to change this behavior:

gantt.config.auto_scheduling_use_progress = true;

gantt.init("gantt_here");

When the config is enabled, completed tasks will be excluded from the critical path and auto scheduling.

Gantt also excludes inactive tasks and links from these calculations.

You can find more details on the API page.

Critical path and slack in v10.0​

In v10.0 the slack and critical-path calculation was reworked. The results no longer depend on auto-scheduling mode options such as move_projects and gap_behavior - the same data always produces the same slack and critical-path values.

A few related behavior notes:

  • A task is critical when its total slack is not greater than zero. Completed tasks (when use_progress is enabled) and tasks that belong to a dependency loop are never critical.
  • getTotalSlack and getFreeSlack return 0 (instead of undefined) for tasks excluded from the calculation - tasks in a dependency loop, and completed tasks when use_progress is enabled.

Choosing a scheduling engine​

Starting in v10.1, the engine option selects the engine for scheduling and analysis. The default is the built-in engine. See PlanningEngine for provider selection and the migration guide for removal of the v10.0 fallback.
